Medical Equipment Configuration Planning for New Hospital Projects in Africa

Views: 100     Author: MECANMED Editorial Team     Publish Time: 2026-10-30      Origin: Site

Inquire

facebook sharing button
twitter sharing button
line sharing button
wechat sharing button
linkedin sharing button
pinterest sharing button
whatsapp sharing button
sharethis sharing button

A hospital-wide equipment configuration should translate each clinical service and room function into equipment requirements, then filter those requirements through infrastructure, maintainability and project budget. This process must begin only after the planned clinical service scope has been defined.

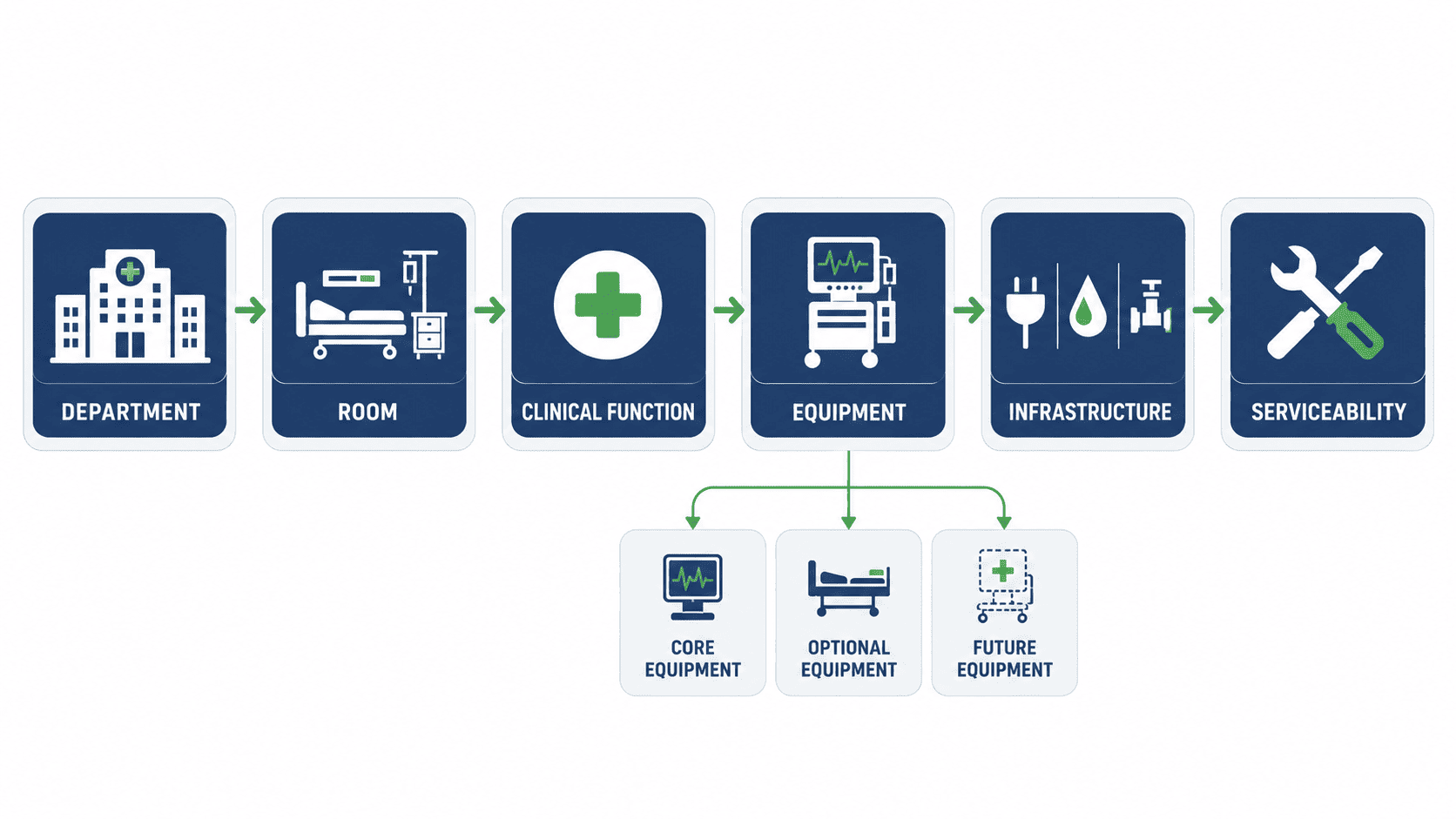

Hospital equipment configuration workflow showing departments, rooms, clinical functions, equipment and infrastructure requirements.

This matters especially for new hospital projects in Africa. Regulations, power standards, and medical gas requirements differ widely from country to country and from project to project. Equipment configurations therefore need to be adapted to the local jurisdiction—not copied from a generic template.

Once the service scope is confirmed, the configuration process moves from department functions down to room-level equipment requirements. Requirements are then classified as core, optional, or future equipment. From there, infrastructure compatibility, serviceability, and budget considerations help shape which requirements make it into a practical procurement plan.

MECANMED supports multi-department medical equipment projects through integrated equipment supply and coordination, backed by its own X-ray manufacturing capability. The following framework explains how to translate a defined hospital service scope into a structured equipment configuration.

Convert Hospital Services into Department Functions

The first step in hospital equipment configuration is to map the planned healthcare services to the departments that will deliver them.

A hospital service describes what the facility intends to provide. A department establishes where that service is organized and managed. Defining this relationship creates the starting point for identifying the rooms and equipment required later in the planning process.

For example, if a hospital plans to offer diagnostic imaging, surgery, lab testing, and inpatient care, it would create the corresponding radiology, operating room, laboratory, and inpatient ward functions.

The mapping becomes more detailed when a single service covers several distinct clinical activities. Diagnostic imaging, for instance, may include general radiography and ultrasound, while a laboratory service may span hematology, clinical chemistry, and other testing disciplines. These activities help define what each department is responsible for and how far its scope extends.

A hospital service-to-department mapping may look like this:

Planned hospital service

Corresponding department or service unit

Scope to establish

Diagnostic imaging

Radiology Department

Imaging services the hospital intends to provide

Surgical treatment

Operating Room Department

Types of surgical procedures and associated services

Diagnostic laboratory testing

Laboratory Department

Testing disciplines the laboratory will support

Hemodialysis treatment

Hemodialysis Unit

Dialysis services planned for the facility

Inpatient care

Inpatient Ward

Patient care services and intended level of care

Emergency assessment and treatment

Emergency Department

Emergency services and clinical activities to be delivered

Medical education and clinical skills training

Medical Education or Skills Training Unit

Teaching activities and practical training scope

This mapping is illustrative only. Department names and organizational structures may vary with the hospital's approved service plan and local requirements.

The purpose of this step is not to select equipment. It is to establish which departments need to be planned and what responsibilities each department will have.

This distinction matters because the same service category can mean different things at different hospitals. A facility that offers only general radiography may structure its radiology department differently from a specialist diagnostic center that provides multiple imaging modalities. Likewise, a laboratory that performs routine blood tests may have a narrower departmental scope than one that offers a broader range of diagnostic testing.

The output of this step should be a confirmed service-to-department list for the hospital. This list then becomes the basis for the next stage: identifying the functional rooms within each department.

Convert Departments into Room-Level Equipment Requirements

Once the department structure is established, each department must be broken down into rooms according to their intended functions. Equipment requirements are then assigned to individual rooms rather than to the department as a whole.

This step is important because different rooms within the same department can perform different tasks and therefore require different equipment.

For example, a radiology department may contain an X-ray examination room and a separate control room. The examination room houses the imaging system and patient positioning equipment, while the control room houses the operator's workstation and related control equipment.

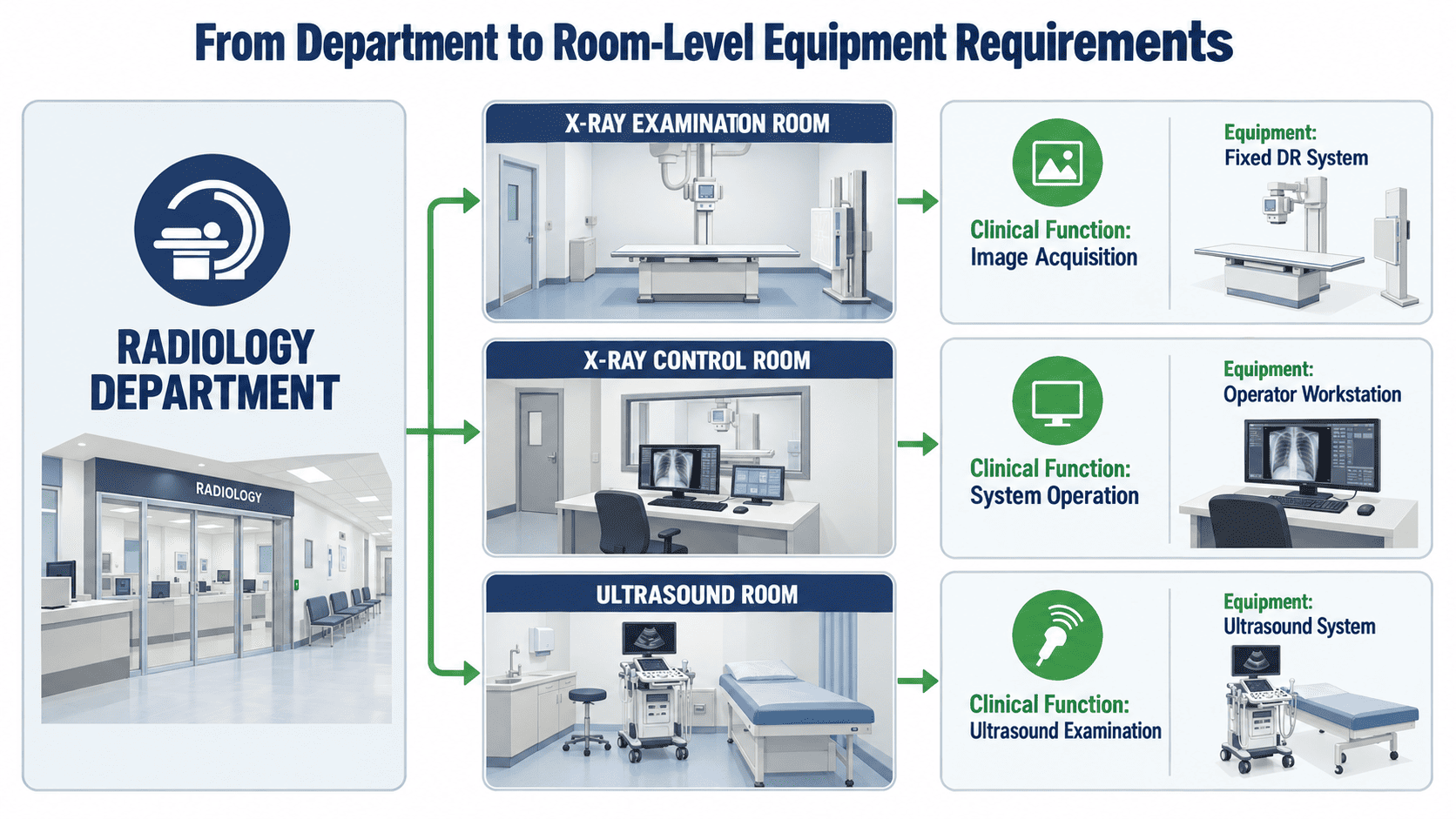

Radiology department room-level equipment configuration showing X-ray and ultrasound rooms, clinical functions and equipment.

Similarly, a laboratory may use separate rooms or designated areas for sample collection, hematology testing and clinical chemistry testing. These spaces have different operational functions and should not automatically receive identical equipment lists.

A room-level equipment matrix makes these differences explicit.

Example: Radiology Department

Room

Primary function

Equipment requirements

General X-ray Examination Room

Position patients and acquire X-ray images

Fixed DR or other specified X-ray system, patient positioning equipment and required imaging accessories

X-ray Control Room

Operate the imaging system and manage image acquisition

Operator workstation, acquisition computer and associated control equipment

Ultrasound Examination Room

Perform ultrasound examinations

Ultrasound system, appropriate probes and examination couch or bed

Image Review or Reporting Room

Review images and prepare diagnostic reports, where provided

Diagnostic workstation and appropriate display equipment based on the reporting workflow

Example: Laboratory Department

Room

Primary function

Equipment requirements

Sample Collection Room

Collect and label patient samples

Phlebotomy chair, sample collection trolley and relevant sample handling supplies

Hematology Testing Room

Perform blood cell analysis

Hematology analyzer, supporting sample handling equipment and any required accessories

Clinical Chemistry Testing Room

Perform biochemical analysis

Biochemistry analyzer and supporting equipment required for the planned testing workflow

Sample Preparation Area

Prepare samples before analysis

Centrifuge, laboratory workbench and other equipment required by the laboratory workflow

These tables show how room functions shape equipment selection. The equipment listed is not a universal specification—final requirements depend on the actual service scope, room layout, and intended workflow.

The tables show why a department-level equipment list on its own is not enough. A radiology department may need both imaging equipment and a separate operator workstation, yet these items serve different room functions. A laboratory may need different analyzers in different testing areas rather than a single undifferentiated list of lab equipment.

The same principle applies to operating rooms, emergency departments, and inpatient wards. Equipment should be assigned based on the activities performed in each room—not simply because the room belongs to a particular department.

At this stage, the goal is to establish the relationship between department, room, clinical function, and required equipment. Procurement priorities and infrastructure compatibility are assessed in later steps.

Apply the Core, Optional and Future Equipment Structure

Once room-level equipment requirements are identified, the next step is to determine when each item is needed.

A hospital may need a broad range of equipment across its departments, but not every item has to be purchased before opening. Separating equipment into core, optional, and future categories helps the project owner set an initial procurement scope while keeping a structured plan for later expansion.

The classification should be applied to specific equipment items, based on the hospital's confirmed service scope.

  • Core equipment: Equipment needed to deliver the clinical services planned for opening.

  • Optional equipment: Equipment that adds capacity, functionality, or convenience but is not essential to the confirmed opening-day service scope.

  • Future equipment: Equipment intended for a later phase—for example, a new clinical service, additional capacity, or an expansion of the hospital's capabilities.

Example: Applying the Structure to Specific Equipment

The following examples show how individual equipment items can be classified. They are hypothetical planning scenarios, not a standard equipment package for every African hospital.

Department

Core equipment

Optional equipment

Future equipment

Radiology

Fixed DR X-ray system and required image acquisition workstation for a hospital whose opening-day imaging service includes general radiography

A second ultrasound system if the initial examination workload can be covered by the planned system

CT scanner if CT services are planned for a later expansion phase

Laboratory

Hematology analyzer, biochemistry analyzer and centrifuge where these are required for the confirmed opening-day test menu

An additional analyzer or automated sample handling system if the initial workload does not require it

Microbiology analyzer or other specialized testing equipment if the corresponding testing service is introduced later

Operating Room

Operating table, surgical lights, anesthesia machine and patient monitor for the planned operating room and procedures

Additional surgical equipment for procedures outside the initial operating scope

Specialized surgical systems for procedures planned for a later clinical expansion

Inpatient Ward

Patient beds, required bedside equipment and patient monitoring devices appropriate to the planned level of care

Additional monitoring devices or specialized bedside equipment beyond the initial operational requirement

Equipment for a future high-dependency or specialist care area

The classification depends on the project, not on the equipment category itself.

For example, a CT scanner is not automatically future equipment. It should be classified as core if CT examinations are part of the hospital's confirmed opening-day service scope. Likewise, patient monitors may be essential in one clinical area but optional in another, depending on the intended level of care.

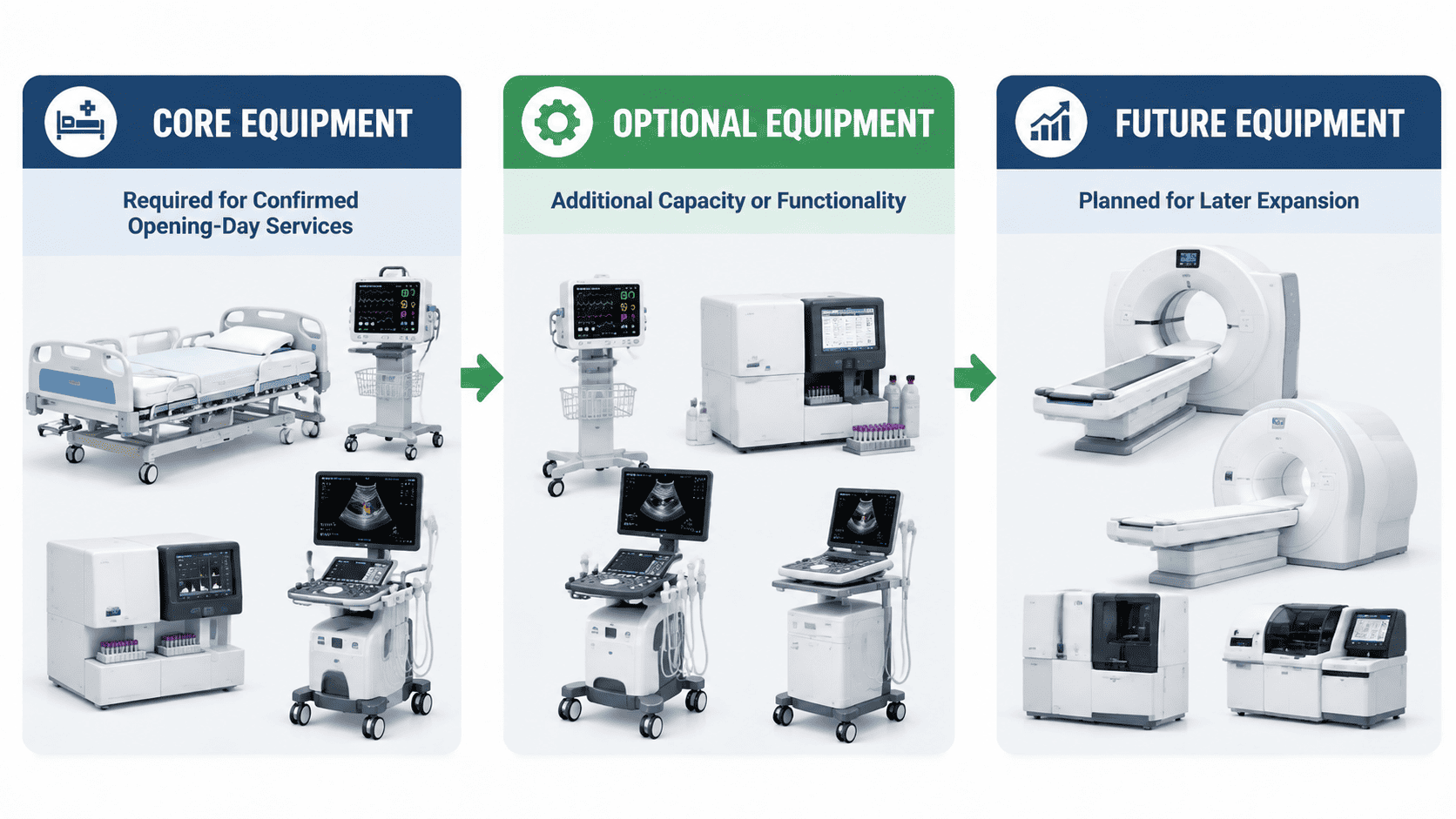

Core, optional and future hospital equipment categories for phased procurement planning.

Optional equipment should not include anything necessary to deliver a service the hospital has already committed to providing. Future equipment should reflect a deliberate later-phase requirement—not an unresolved item simply left off the initial list.

Once the classification is complete, the project owner can separate equipment needed for initial operations from items that can be procured later. This gives procurement planning and later budget review a more transparent basis.

Filter the Configuration Through Infrastructure Compatibility

An equipment selection that is clinically appropriate may still be unsuitable if the facility cannot support its installation or operation.

Before finalizing the equipment configuration, check infrastructure compatibility. This review should involve the relevant technical specialists. It should also draw on the actual building plans, the equipment requirements, and the applicable local rules.

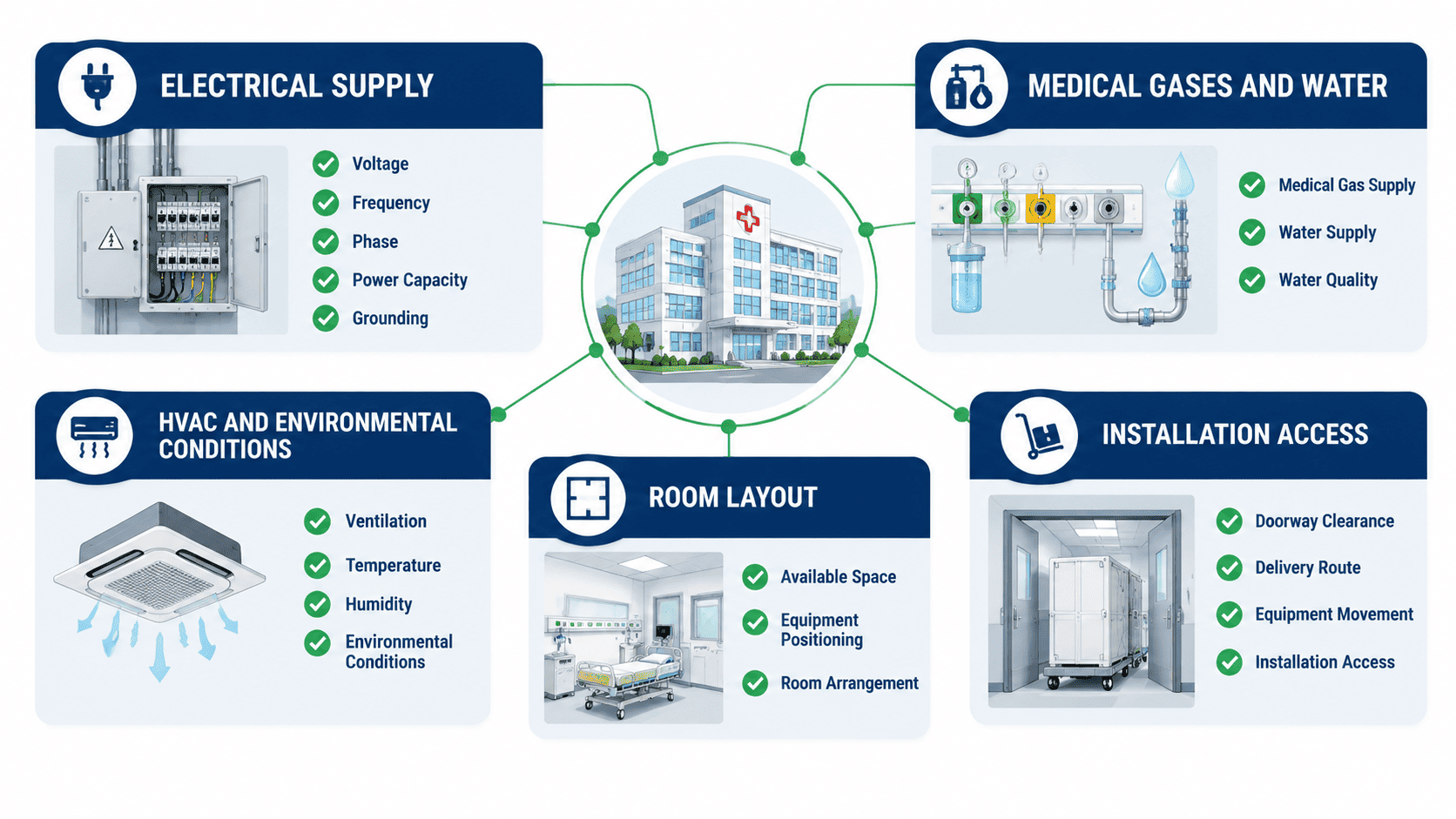

Hospital equipment infrastructure checklist covering electrical supply, medical gases, water, HVAC, room layout and installation access.

Electrical supply

Check the power supply available at the site: voltage, frequency, phase, power capacity, grounding, and power quality. Then compare these against what each proposed system requires. Equipment with higher power demands, or specific electrical requirements, may need dedicated circuits or other electrical provisions.

For imaging equipment, confirm two things before finalizing the system configuration: the manufacturer's electrical requirements, and the proposed installation conditions.

Power stability may be a concern in some settings. In those cases, work with qualified electrical personnel to assess the appropriate protective measures. Do not assume one backup-power solution suits every device.

Medical gases and water

Medical gas requirements depend on two things: the clinical function of the space and the equipment selected. Operating rooms, critical care areas, and other clinical spaces may therefore need different gas services and connection arrangements.

Water requirements also vary by application. Laboratory equipment may have specific water-quality requirements. Hemodialysis is different: it requires appropriate water treatment, and the water quality must be verified for the intended system.

The configuration should identify these requirements for each department. It should not assume that every department needs the same utilities.

HVAC and environmental conditions

Temperature, humidity, ventilation, and other environmental conditions should all be checked. They should each be checked against the equipment manufacturer's specifications and the facility's own applicable requirements.

Some equipment has specific environmental limits that affect where it can be located or how it is installed. These limits should be identified early—before equipment is selected—so that the planned room is not asked to support equipment it cannot accommodate.

Room layout and installation access

Check the following when assessing whether the room and access routes can support the equipment:

Room requirements

  • Physical dimensions of the equipment

  • Operating clearances

  • Service access

  • Movement of patients and staff

Access constraints

  • Delivery routes

  • Door openings

  • Corridors

  • Lifts

  • Other access restrictions

For imaging rooms, assess the applicable radiation protection requirements. Also assess the design conditions specific to the room. Both must be established for the actual equipment, layout, jurisdiction, and facility type—not copied from a generic template.

The configuration decision should follow the verified site conditions. Where a critical requirement remains unconfirmed, record it as an outstanding item. Do not assume the equipment can be installed as proposed.

Filter the Configuration Through Serviceability

Equipment suitability does not end with installation. The project must also consider maintenance and support over the full service life of the selected systems.

A configuration may meet clinical requirements yet still be hard to maintain reliably. That mismatch can create avoidable operational difficulties after the hospital opens.

The serviceability review should address four areas.

Maintenance and technical support

Identify the maintenance requirements for each equipment category: routine servicing, troubleshooting, and the availability of qualified technical personnel. Then confirm the actual support arrangements for the project rather than assuming that all equipment can receive immediate local service.

Spare parts and consumables

Determine which spare parts and consumables are required, how often they will be needed, and how they can be replenished. Availability, lead times, compatibility, and storage requirements may all affect which equipment option is the practical choice.

Training and operational readiness

Consider the training needed for clinical users and technical personnel. Training scope should reflect the equipment supplied and the services planned, together with the arrangements agreed for the project.

Balance Clinical Need and Project Budget Without Creating a Price List

A workable configuration must balance clinical requirements with the project's available resources. The goal is not to select the cheapest possible equipment package, nor to maximize the number of devices. Rather, it is to identify the configuration that supports the planned services within the project's technical and financial constraints.

Budget review should follow the clinical and technical assessment rather than replace it.

When the initial package exceeds the available budget, review the configuration in a structured order:

1. Protect essential opening-day services. Identify the equipment required to deliver the confirmed clinical scope.

2. Review optional items. Determine whether proposed additions can be deferred without compromising planned services.

3. Evaluate alternative configurations. Compare technically suitable options against performance requirements, operating conditions, maintenance needs, and total cost of ownership.

4. Plan future expansion. Identify equipment that can be procured later, provided the initial facility design and infrastructure can accommodate the intended expansion.

5. Document unresolved decisions. Record items awaiting budget approval, technical confirmation, or a decision on the service scope.

A budget adjustment should not be made by removing equipment arbitrarily. For example, deferring an advanced imaging system may be reasonable if the service falls outside the opening-day scope and the project has an appropriate referral arrangement. Removing an analyzer needed for the laboratory's confirmed test menu, however, may have a very different operational impact.

Example: When infrastructure changes the configuration

Consider an illustrative project. Its proposed equipment package includes a system that needs a more stable electrical supply than the site can currently provide.

The appropriate response is not simply to replace the system with a cheaper model. The project should instead compare the feasible options. These include upgrading the electrical infrastructure, selecting another system that meets the clinical requirements under the verified conditions, and deferring the service to a later phase where this is clinically reasonable.

The decision should weigh several factors. These include technical suitability, the cost and feasibility of infrastructure work, installation timing, and the consequences for planned clinical operations.

Infrastructure readiness, serviceability, and budget should all shape configuration decisions in this way. Each change needs a clear rationale linked to the project conditions.

Build the Final Procurement Package and BOQ Structure

Five inputs need to be reviewed first: clinical scope, room functions, equipment priorities, infrastructure requirements, and service arrangements. Once they are confirmed, the configuration can be translated into a preliminary Bill of Quantities (BOQ) or equipment schedule.

The purpose of this document is to make the procurement scope clear enough to support technical review, quotation, and subsequent confirmation.

A useful BOQ structure may include:

Field

Purpose

Department

Identifies the clinical department

Room ID or function

Connects the item to its intended location or use

Equipment description

Defines the required equipment category

Quantity

Records the confirmed or provisional quantity and its status

Technical requirements

Captures essential specifications and compatibility conditions

Utility requirements

Identifies relevant electrical, water, gas or environmental provisions

Procurement phase

Distinguishes core, optional and future requirements

Outstanding items

Records information still needed before finalization

The level of detail should match the procurement stage. During early planning, some quantities or specifications may remain provisional. These should be tightened as the project advances. Before final procurement, the technical requirements, quantities, installation conditions, and commercial terms must all be confirmed.

A preliminary BOQ is not a final technical specification, a quotation, or a complete installation design. It provides a structured basis for the next stage of project development.

The same structure also helps identify missing scope. A proposed equipment item may require accessories, supporting equipment, utility provisions, or consumables. These should be reviewed explicitly, not assumed to be included.

Clear scope definition helps the project owner compare quotations on a more consistent basis. It also reduces the risk of overlooking requirements that emerge only after purchasing begins.

Real Project Example: Coordinating a Multi-Department Medical Center in Zimbabwe

MECANMED supplied medical equipment for a new medical center in Harare, Zimbabwe. The project covered five areas: imaging, the operating room, medical furniture, medical consumables, and the Central Sterile Supply Department (CSSD).

The customer needed equipment from multiple categories and wanted to avoid the time and effort involved in sourcing products and coordinating deliveries separately. MECANMED consolidated the procurement within one project scope, covering equipment selection, order coordination and logistics.

Adjusting the X-Ray Power Requirement Before Procurement

The X-ray equipment was initially recorded as requiring 380V. During requirement confirmation, the customer confirmed 220V as the actual voltage. The configuration was updated accordingly before the order was finalized.

This illustrates why equipment specifications should be checked against the customer's actual requirements before procurement. A mismatch in a basic specification such as supply voltage can make the selected equipment unsuitable for the intended installation. The confirmed electrical requirements must therefore be checked against the manufacturer's specifications and the installation conditions.

WhatsApp confirmation of the X-ray machine's 220V power requirement and revised equipment specification.

Coordinating Equipment Across Five Areas

The consolidated order covered the following categories:

  • Imaging: X-ray equipment, ultrasound and related imaging accessories.

  • Operating room: Patient monitoring, ECG, suction equipment and surgical instruments.

  • Medical furniture: Hospital beds, bedside tables, trolleys and examination couches.

  • Medical consumables: Syringes, oxygen masks and IV cannulas.

  • CSSD: Sterilization equipment and related consumables.

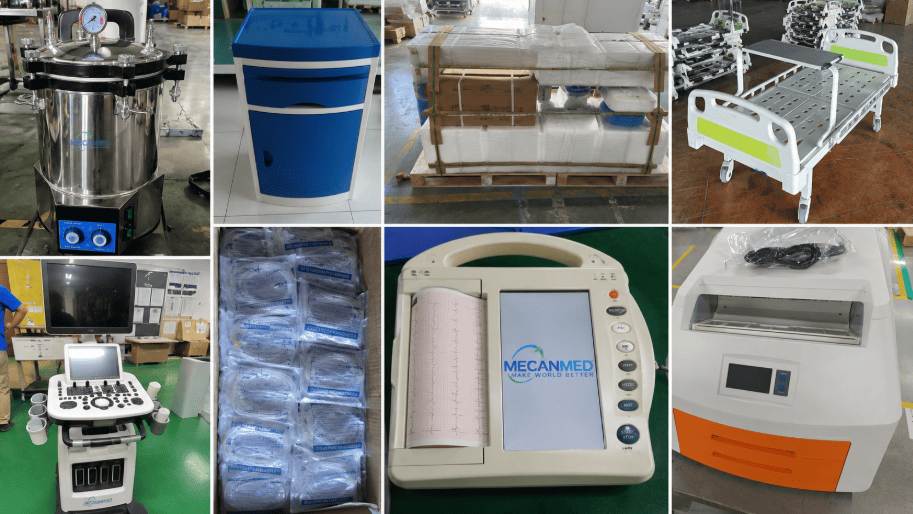

Medical equipment supplied for imaging, operating room, CSSD, medical furniture and consumables in Zimbabwe.

Bringing these categories into one procurement arrangement reduced the need for the customer to coordinate each equipment category separately. It also provided a consolidated scope for order and delivery coordination.

Project Outcome

The equipment was delivered successfully, and the customer completed installation and commissioning. The equipment was subsequently put into use at the medical center.

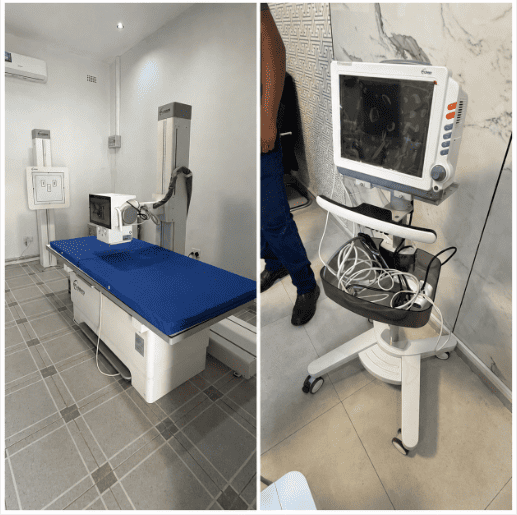

Installed X-ray system and patient monitor at a medical center in Zimbabwe.

The customer later referred another prospective customer to MECANMED, and that referral resulted in a further sale.

This project demonstrates how multi-department equipment procurement involves more than selecting individual products. It requires confirming technical requirements, coordinating different equipment categories and organizing delivery around the needs of the facility. The project also shows how a consolidated procurement arrangement can simplify purchasing for a new medical center.

Coordinating Equipment Requirements Across Departments

A hospital equipment project often involves multiple departments. Each has its own technical requirements, accessories, installation conditions, and procurement schedules. Managing these requirements separately can make it difficult to keep the equipment scope consistent across the whole project.

A coordinated configuration process helps connect department-level requirements with the overall procurement plan. This includes:

  • Consolidating equipment lists

  • Identifying overlapping requirements

  • Confirming that accessories and supporting equipment are accounted for

  • Clarifying outstanding technical or commercial issues before procurement

For hospital owners and project contractors, a single coordination window can simplify communication across equipment categories and give a clearer view of the agreed project scope. However, responsibility for technical specifications, regulatory compliance, installation, and after-sales support must still be defined in each project.

With more than 200 hospital projects across 157 countries and regions, MECANMED integrates equipment across departments. Our own X-ray factory supports this, and we act as a single point of responsibility for hospital owners—turning complex cross-departmental requirements into one coordinated procurement package.

Request a Hospital Equipment Configuration Review

Whether you are planning a new hospital, expanding an existing facility, or preparing an initial equipment budget, MECANMED can help. We review the project information you have and structure equipment requirements across the relevant departments.

Share your department list, floor plan, preliminary BOQ or equipment requirements to begin the review. If some documents are not yet available, the project scope and current planning stage can provide a starting point.

If you would like to discuss your hospital project with our team, please visit our Contact Us page to get in touch with MECANMED.
